Cloud Migration Lift and Shift: An SMB Playbook
Plan and run a cloud migration lift and shift for your SMB. Practical assessment, runbook, testing, cutover, and post-migration tips from CloudOrbis.
Plan and run a cloud migration lift and shift for your SMB. Practical assessment, runbook, testing, cutover, and post-migration tips from CloudOrbis.

The server-room lease is ending, your application vendor hasn't approved a replacement system, and the clinic manager wants reassurance that staff can still open patient records after the move. You don't need a grand transformation programme. You need a controlled relocation, a credible operating budget, and someone accountable if the switch fails.
Lift and shift, also called rehosting, means moving existing applications, servers, and data to hosted infrastructure with minimal architectural redesign. For an SMB facing a premises move, hardware replacement, or contract deadline, it can be the fastest honest route to cloud. It isn't a promise that an unchanged application will suddenly become cheaper or easier to manage.
Canadian businesses aren't experimenting at the margins anymore. 48% used cloud computing in 2023, up three percentage points from 2021, according to Statistics Canada's digital technology survey. That's context for evaluating a move, not a reason to migrate every server.

A sensible cloud migration lift and shift decision separates the immediate deadline from the eventual application roadmap. Move a suitable workload because relocation solves a business problem. Do not turn that decision into a commitment to run the same oversized environment indefinitely.
For another perspective on the approach, consider digna's lift and shift insights. Keep the wider business benefits of cloud migration separate from benefits your specific application can deliver.
Practical rule: Approve the move and the ongoing operating model together. A migration budget without an operating budget is an unfinished business case.
Work through assessment, planning, tools, the runbook, testing, cutover, and optimisation in that order. You should finish with a defensible plan, a rehearsed rollback posture, and a defined post-migration cost-control window.
Start with a workload register, not a migration-tool demonstration. Keep the summary short enough for an operations director to review, with supporting technical evidence attached.
Give every workload a business owner and a proposed disposition: rehost, redesign, replace, retain, or retire. If nobody owns an application's business outcome, nobody can credibly approve its migration.
Use your IT asset inventory as the starting point, then investigate what each server supports.
A manufacturer's production application may depend on local equipment. A legal practice's document system may rely on an overlooked indexing service. Treat these as discovery questions, not reasons to assume everything belongs in cloud.
Use migration guidance from Cloudvara as an additional planning reference when comparing migration approaches. Your actual disposition decision should still follow dependency evidence and business requirements.
Canadian data residency isn't the same as sovereignty or compliance. PIPEDA generally doesn't impose a universal Canadian-storage requirement, and organisations remain accountable for information handled by processors; provincial health-information obligations can also require privacy-impact assessment, as outlined in this Canadian data-residency guide.
For healthcare, legal, and finance workloads, map primary data, backups, logs, identities, support access, and encryption-key control. Have the privacy lead review applicable obligations before approving the destination.
Rehost when the workload is supported and its dependencies are manageable. Redesign or retain it when hardware coupling, licensing, latency, or unresolved privacy requirements make an unchanged move indefensible.
Choose the destination before committing to the migration tool. Otherwise, you risk selecting whatever infrastructure makes replication convenient rather than what your organisation can operate responsibly.
For a Microsoft-heavy SMB, put Azure Canada Central and Canada East on the shortlist. Compare them with an alternative hyperscaler destination against the workload register, including service availability, connectivity, recovery design, and permitted data flows. A Canadian region is a candidate, not a compliance certificate.

| Option to evaluate | Appropriate decision question | Approval condition |
|---|---|---|
| Azure Migrate | Should this existing server workload be rehosted in Azure? | Validate compatibility, sizing, dependencies, and migration method. |
| Azure Virtual Desktop | Does the user desktop environment need relocation? | Test application behaviour, peripherals, profiles, and licensing. |
| Microsoft 365 modernisation | Should this business function move instead of its server? | Confirm workflow, data, retention, and integration requirements. |
| Retained or hybrid infrastructure | Does this workload still need local infrastructure? | Document the constraint and a future review point. |
Don't bundle Microsoft 365 replacement work into a rehosting project without acknowledging the additional business change. These are different decisions, even when the same team delivers them.
An internal team should lead execution only if it can also cover incidents, security administration, billing reviews, and recovery. Otherwise, use a managed or co-managed partner with explicit responsibilities and escalation arrangements. The Canadian cloud-provider comparison can support that shortlist.
Before signing, resolve migration-window allowances, ingress and egress charges, retrieval procedures, deletion requirements, and information retained after departure. These are explicit concerns in the Canadian Centre for Cyber Security's cloud-contract guidance.
My recommendation: evaluate Azure rehosting for suitable Microsoft server workloads, assess Microsoft 365 separately, and buy operating support if your team can't sustain the destination.
Statistics Canada's migration provides a useful execution model, not a throughput benchmark for your business. Its programme used 31 migration waves, with a reported target of 100–120 servers per month, supported by formal governance and repeatable pipelines, according to its documented cloud journey.
The transferable lesson is sequencing. Let the team learn on a lower-impact environment before authorising a business-critical move.

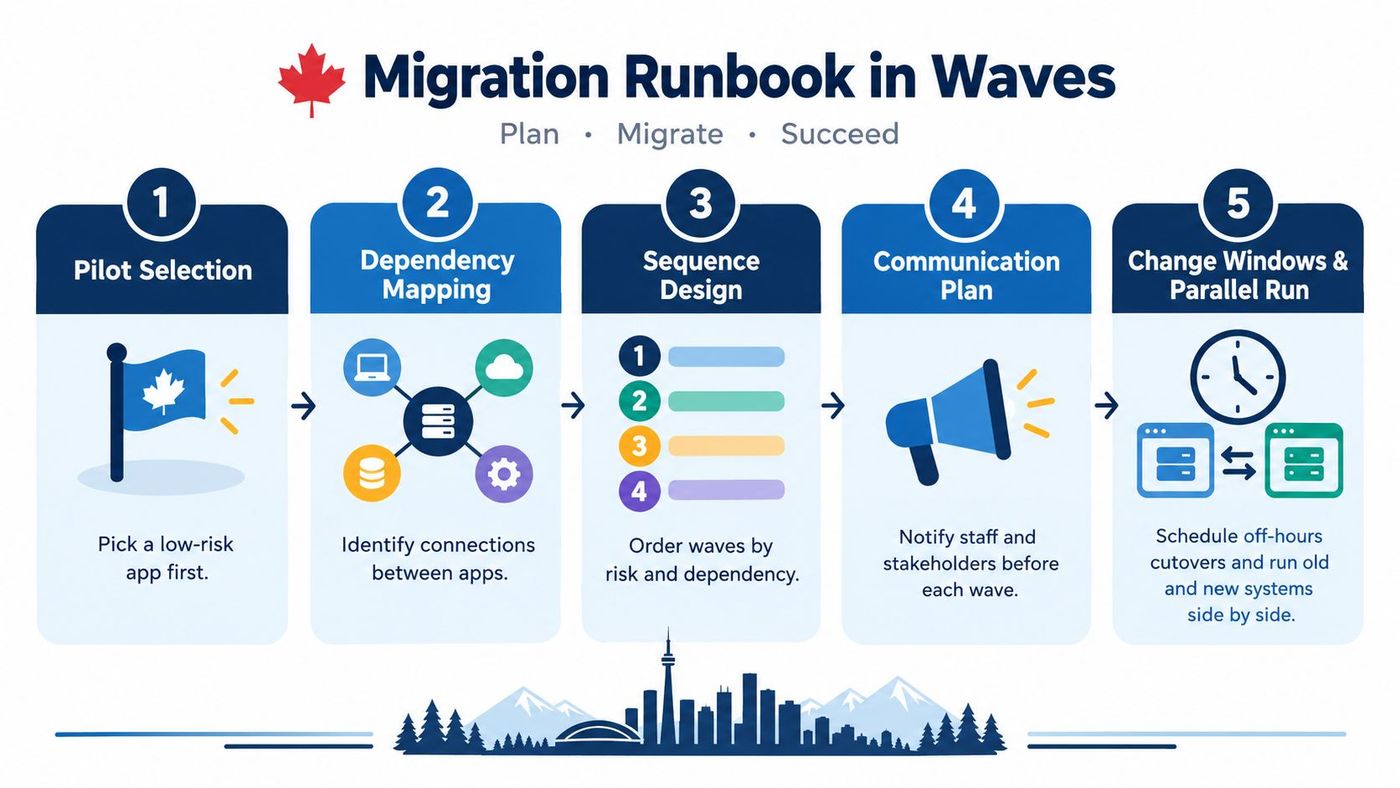

Select a pilot that matters enough to test properly but won't threaten core operations if delayed. Include representative authentication, monitoring, backup, and support requirements. A disconnected test server won't expose the problems that affect staff.
Use a proposed cadence rather than promising an arbitrary completion date:
For each wave, identify who performs each action, who verifies it, and who communicates with users. Record the change window, prerequisites, stop conditions, escalation contacts, and the exact point at which rollback remains feasible.
A wave is complete when the business owner accepts the service and the operations team accepts responsibility for running it. A successful replication job isn't acceptance.
Define whether the old environment remains read-only, isolated, or available for fallback. Don't allow independent writes to both environments unless the application design explicitly supports reconciliation.
Notify staff before the change window with a clear outage expectation and support route. After the wave, hold a short review covering failed changes, rollback decisions, incidents, and recovery-test results.
Source infrastructure should remain protected until the required reconciliation and acceptance checks pass. Then assign a retirement task with an owner. Otherwise, you can end up paying to operate both environments without an intentional reason.
Minimal application change doesn't justify minimal testing. Rehosting still changes the environment around the application, including network paths, access controls, storage behaviour, and operational responsibilities.

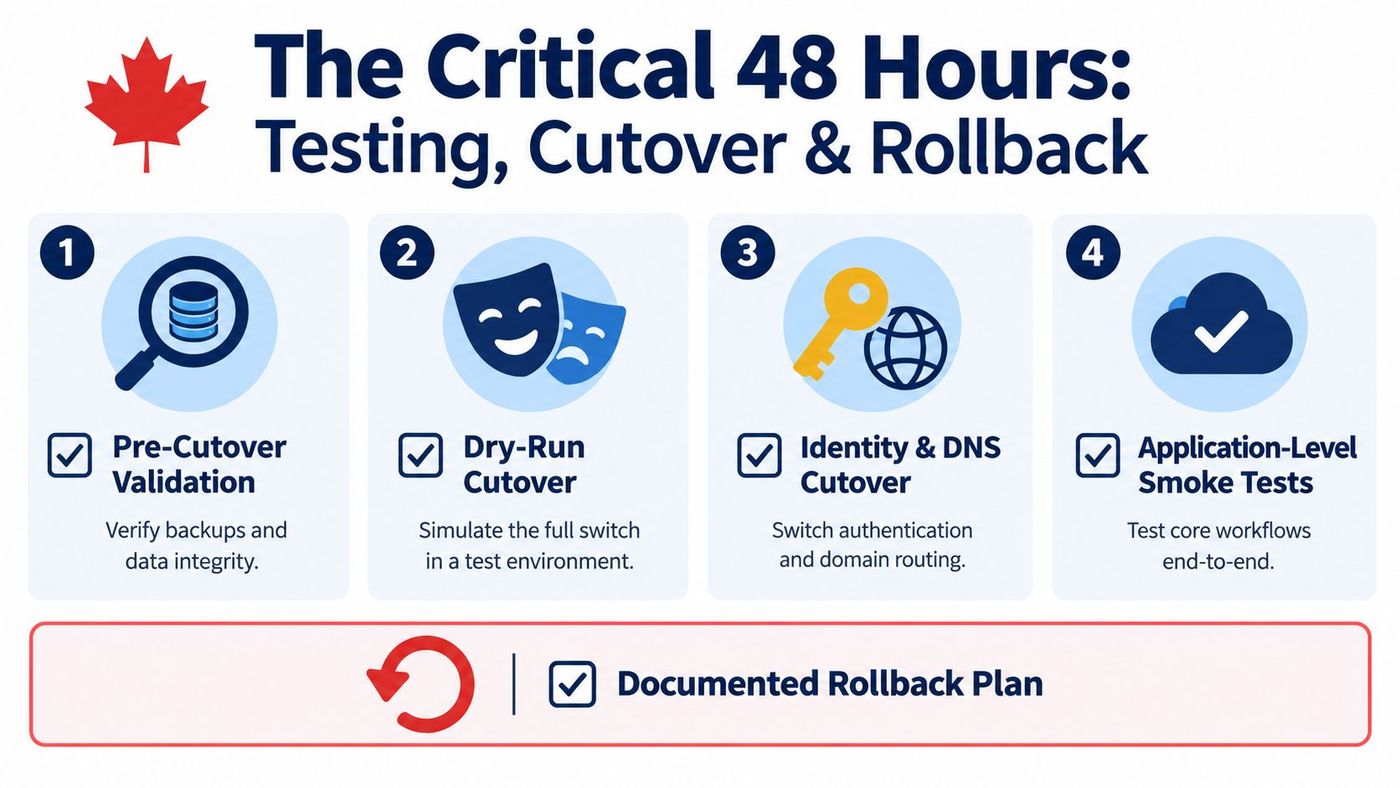

The highest-stakes period is the cutover window and its immediate aftermath. Your runbook describes intended actions; testing must prove the service can survive them.

The Canadian Centre for Cyber Security identifies organisational responsibilities for migration monitoring, encryption in transit, backup, and protection of temporary and final storage in its defence-in-depth cloud guidance. Cloud hosting doesn't transfer those responsibilities away from your team.
Use the workload register's acceptance requirements to define evidence:
Strengthen the recovery procedure with these backup and recovery strategies. For change-control discipline, consider Server Scheduler's guidance to reduce failed changes in cloud, then translate the relevant controls into named approvals.
Write rollback criteria in operational terms: failed critical transactions, unreconciled records, unacceptable response times, or an unresolved security control. Set workload-specific thresholds before the change window, not during an outage.
Cutover gate: No production traffic until the designated approvers accept the evidence and confirm that the recovery path remains usable.
Specify who can order rollback and how data written after cutover will be handled. If nobody can explain how the business returns safely to the source environment, you don't have a rollback plan. You have a hope that the cutover succeeds.
The morning after cutover, assign someone to review the live bill and resource usage. Don't wait for finance to discover that the environment costs more than expected.
Statistics Canada's 2024–25 departmental results report stated that funding for continued cloud operations wasn't included in planned spending beginning in 2026–27, pending an enterprise-wide funding model. That was a reported planning gap, not proof of a subsequent shutdown, but it illustrates why migration approval and operating funding must be handled together in the departmental results report.

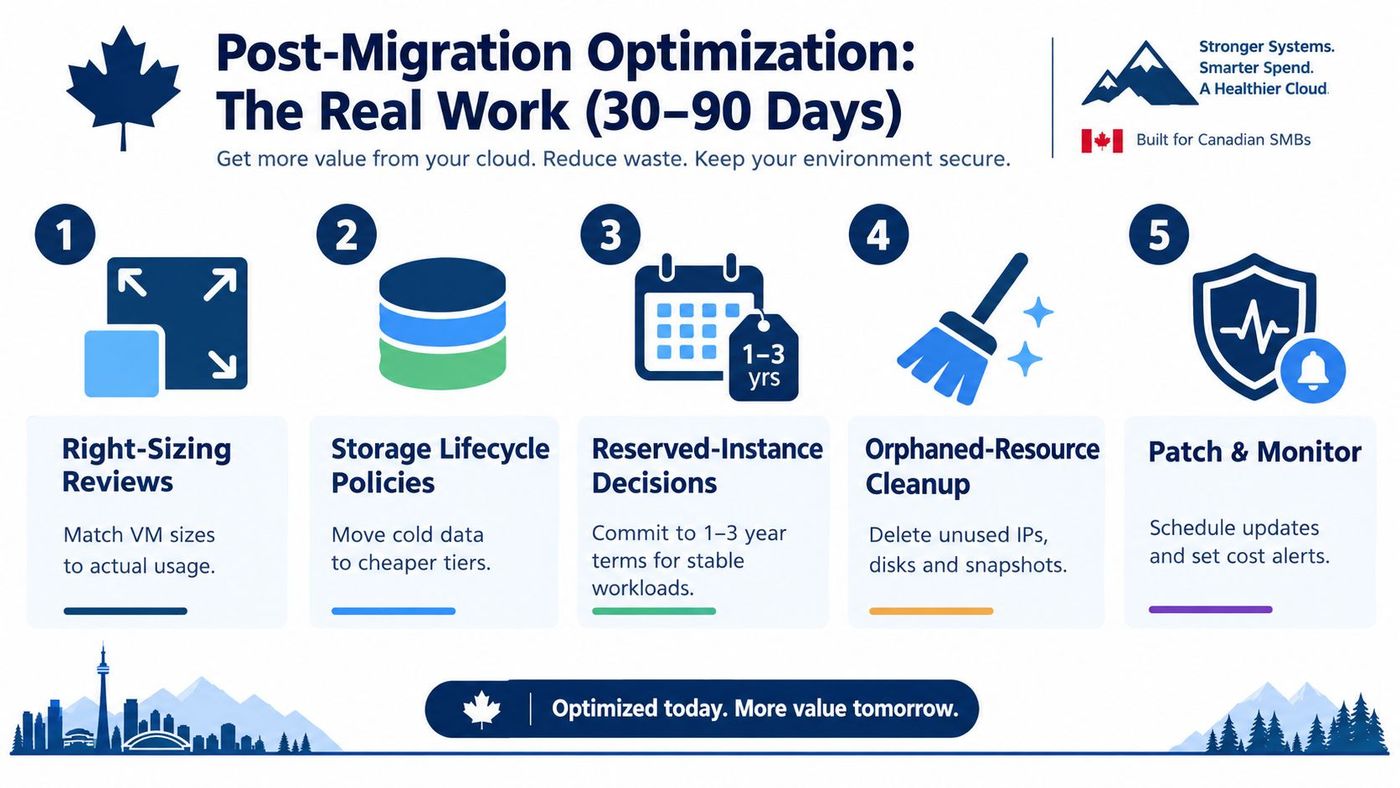

Set a 30–90-day optimisation window as a project requirement, not a savings guarantee. The business case deserves scrutiny: an Accenture survey reported that only 34% of Canadian respondents achieved the full expected cloud value, while 18% were completely confident migration would deliver expected value on schedule, according to the Canadian cloud-value findings.
| Control | Decision the owner must make |
|---|---|
| Right-sizing | Match provisioned capacity to observed demand and performance requirements. |
| Storage lifecycle | Align tiers and retention with access patterns and obligations. |
| Capacity commitments | Commit only after demand stabilises and the commercial terms make sense. |
| Resource cleanup | Remove verified unused disks, snapshots, addresses, and abandoned environments. |
| Patching and monitoring | Assign maintenance ownership and actionable operational and cost alerts. |
Use cloud cost-management practices to establish workload-level budgets and safe shutdown schedules for non-production systems.
The checkpoint should produce a written decision: retain the current design, resize it, modernise selected components, or reconsider placement. Include support effort and recovery readiness alongside spending. A cheaper environment that staff can't reliably operate isn't an improvement.
Treat the following as an action horizon, not a guaranteed migration duration. Keep a deadline for producing evidence, but don't let a calendar date override a failed safety gate.
Keep these records together. An operations director should be able to see what's approved, what remains unresolved, and who must act without reconstructing the project from chat messages.
Can we promise customers that everything stays in Canada?
Only make that promise when your contracts and verified data flows support it. Include support access and secondary copies in the scope of the statement.
Does migration approval also mean compliance approval?
No. Ask the responsible privacy or compliance lead to document acceptance under the obligations that apply to your organisation.
Must everything finish within this action horizon?
No. Extend the schedule when dependencies or failed tests justify it. A controlled delay is preferable to an unsupported production service.
Should we modernise immediately after moving?
Approve a separate decision based on observed operating evidence. Don't turn an urgent relocation into an open-ended redevelopment project.
The useful outcome isn't a smaller server room. It's an environment your business can fund, operate, recover, and explain to customers and auditors.
CloudOrbis Inc. offers managed cloud migration, cybersecurity, backup and recovery, and ongoing IT support for small and mid-sized Canadian businesses. If you need hands-on help assessing workloads, planning migration waves, and controlling costs after cutover, visit CloudOrbis Inc. to discuss your deadline, application dependencies, and operating requirements.
